Astor Enerji

Stock Symbol: ASTOR | Exchange: Istanbul

Table of Contents

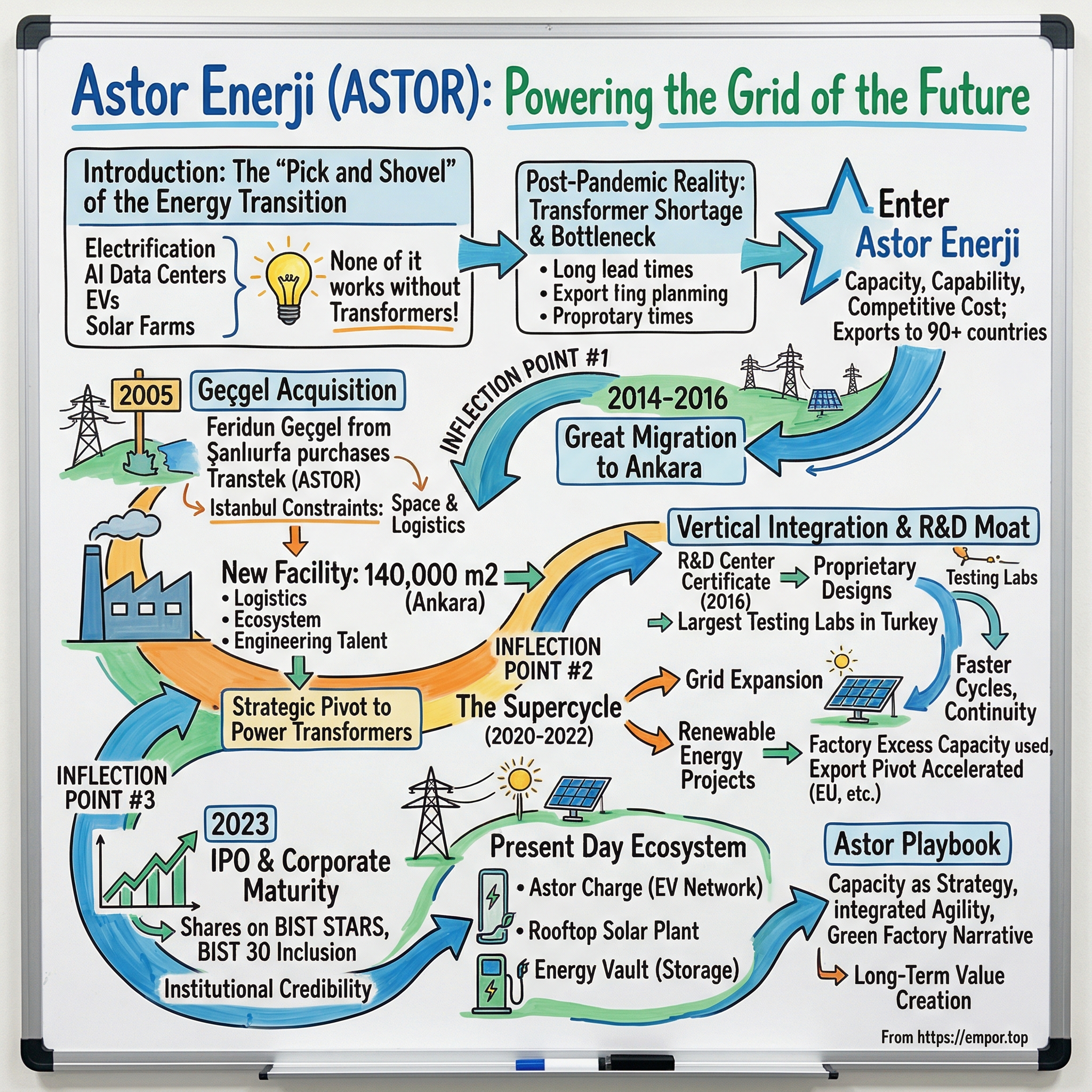

Astor Enerji: Powering the Grid of the Future

I. Introduction: The "Pick and Shovel" of the Energy Transition

Picture the modern energy landscape: AI data centers consuming megawatts of power, solar farms stretching across desert plains, electric vehicles multiplying on highways, and wind turbines spinning silently on distant shores. The world obsesses over the glamorous front-end of electrification—Tesla's sleek vehicles, towering wind turbines, acres of photovoltaic panels. But here is a contrarian truth that rarely makes headlines: none of it works without transformers.

A transformer is among the oldest and most essential devices in electrical engineering, invented in the 1880s. A typical one has a two-sided core made of iron or steel with copper wire wrapped around each side. Through electromagnetic induction across the core, current transfers from one coil to the other, and by changing the number of times the wire wraps around each side of the core, engineers can change the voltage that emerges from the device. Every renewable energy project needs transformers to connect to the grid. Every EV charging station requires one to step down high-voltage electricity. Every data center demands massive power transformers to handle its insatiable appetite for electrons.

And here is the uncomfortable reality that has emerged since the pandemic: the country will need many more of them—perhaps twice as many as already exist. The North American Electric Reliability Corp. says the lead time hit roughly 120 weeks (more than two years) in 2024, with large power transformers taking as long as 210 weeks (up to four years). In a world racing toward electrification, the humble transformer has become a bottleneck of epic proportions.

Enter Astor Enerji.

Astor Enerji operates in Ankara and has a production facility covering an area of 140,000 square meters, with 105,000 square meters of indoor space, making it one of Europe's leading transformer manufacturing facilities under one roof. While global giants like Siemens, ABB, and Schneider Electric command premium prices and multi-year wait times, this Turkish industrial heavyweight has positioned itself at the intersection of capacity, capability, and competitive cost—exactly where the world desperately needs more supply.

The company exports its products, including Oil Type Distribution Transformers, Cast Resin Dry Type Transformers, Power Transformers, Medium Voltage Switching Products, Compact Transformer Centers, RMUs, and Metal Clad, to more than 90 countries. From humble origins as a small Istanbul operation, Astor has transformed into a publicly traded juggernaut with trailing twelve-month revenue approaching $776 million and a market capitalization exceeding $2.7 billion.

The thesis is deceptively simple: in an era of chronic transformer shortage, the company that bet on capacity before the crisis struck—and built the manufacturing infrastructure, vertical integration, and testing capabilities to compete with global titans—stands to capture an outsized share of one of the most critical markets of the twenty-first century. This is the Astor story.


II. Pre-History & The Geçgel Acquisition (2000s)

The story begins not with a technology startup in a garage, but with an industrial turnaround play in the bustling commercial corridors of Istanbul. The Company was founded as Transtek Transformatör A.Ş. in 1983 and was renamed Astor Transformatör ve Enerji A.Ş. in 2003. But the transformative moment came in 2005.

In 2005, ASTOR Transformer company was purchased by the Geçgel family and continued its transformer production activities in Istanbul. The patriarch of this acquisition, Feridun Geçgel, came from Şanlıurfa, a city in southeastern Turkey near the Syrian border—a region far from the industrial centers of the country, but one that would shape his entrepreneurial approach.

Feridun Geçgel was born in 1970 in Şanlıurfa. After high school education, he stepped into entrepreneurship. He started his business life founding Özgüney Elektrik A.Ş., beginning with sales of electrical and electronic materials. A few years later, he added transformer sales to his portfolio. In 2005, he purchased ASTOR Transformer as a family and continued transformer production activities in Istanbul.

This was not the profile of a venture-backed founder chasing quick exits. Geçgel was an entrepreneur from Turkey's Anatolian heartland who had methodically built expertise in the electrical equipment trade before making his defining acquisition. He understood the transformer business from the ground up—not just the engineering, but the commercial relationships, the procurement dynamics, and the operational realities of heavy industrial manufacturing.

The early strategy focused on distribution transformers, the smaller units that step down voltage for residential and commercial use. These are the workhorses of electrical grids—less glamorous than the massive power transformers that connect generation plants to transmission lines, but essential nonetheless. The Turkish domestic market, particularly the state grid operator TEİAŞ and various electricity distribution companies, provided the customer base.

But the Istanbul location presented a fundamental constraint. Turkey's largest city was ideal for commerce, finance, and access to European markets. It was terrible for heavy industrial scaling. Urban density meant limited land availability, high real estate costs, and logistical challenges for manufacturing equipment that can weigh hundreds of tons. Astor under the Geçgel family was a "local champion," competitive in the Turkish market but lacking the manufacturing firepower to compete with global giants on major international projects.

The company needed scale. And scale, in transformer manufacturing, meant one thing: space. Lots of it.


III. Inflection Point #1: The Great Migration to Ankara (2014–2016)

The decision was radical: abandon Istanbul entirely and relocate the entire operation to Ankara.

In 2015, the GEÇGEL family decided to organize all its activities in Ankara as the chairman of the board of ASTOR company. This was no incremental step. It was a "bet the company" moment—the kind of decision that either propels a business into a new trajectory or destroys it.

In 2014, the company headquarters and production facility were moved to ASO 1st OIZ. The move occurred in stages, with the initial relocation to the first organized industrial zone followed by the construction of the definitive manufacturing campus in the ASO 2nd Organized Industrial Zone.

Equipped with the latest technology, the new factory located in 2nd OIS (Organized Industrial Site) of Ankara was constructed in 2016, exports Oil Type Distribution Transformers, Cast Resin Dry Type Transformers, Power Transformers, Medium Voltage Switching Products, Compact Transformer Substations, Metal Clad RMU to more than 60 countries.

Why Ankara? The answer reveals sophisticated strategic thinking beyond simple cost reduction.

First, the Ankara Sanayi Odası (ASO) organized industrial zones offered something Istanbul never could: massive, contiguous parcels of land designed specifically for heavy manufacturing. This was not about cheap land for a warehouse; it was about building an integrated manufacturing campus where every production process could be co-located under controlled conditions.

Second, Ankara's location near Turkey's geographic center offered logistical advantages for serving both domestic and export markets. Rail and highway connections to Mediterranean ports meant export capability without Istanbul's urban congestion.

Third, and perhaps most importantly, the organized industrial zone provided access to a localized ecosystem of suppliers, technical schools, and an engineering talent pool from Ankara's universities. Turkey's capital is home to institutions like Middle East Technical University and Ankara University, both with strong engineering programs that could supply the technical workforce a transformer manufacturer needs.

Astor Enerji A.Ĺž. is located in the ASO 2nd Organized Industrial Zone in Sincan, Ankara, on an area of 140,000 square meters, and continues its production activities in its integrated factories with a total closed area. Astor Enerji carries out its production in two integrated units consisting of a 78,000-square-meter main factory and a 27,000-square-meter mechanical manufacturing facility.

Think about that scale. The main factory alone is approximately 840,000 square feet—larger than many automobile assembly plants. This is not a factory; it is a campus designed for industrial flow, where raw materials enter one end and finished transformers weighing hundreds of tons exit the other.

The risk was enormous. Building this facility required massive capital investment before Astor had the global order book to fill it. The family was essentially making a bet that demand would come—or they would be left with a spectacular white elephant.

The outcome vindicated the gamble. The Ankara facility fundamentally changed Astor's unit economics and enabled a strategic pivot: from distribution transformers (small units, lower margins, high volume) to power transformers (massive units, higher margins, longer lead times). In 2024, the first 675 MVA 400/21 kV generator step-up transformer was manufactured. These are the transformers that connect major power plants to transmission grids—the highest-value segment of the market and one where Astor could now compete with global players.


IV. Vertical Integration & The R&D Moat (2016–2020)

The Ankara factory was just the beginning. The next inflection point was a strategic decision that would prove prescient when global supply chains shattered a few years later: vertical integration.

Most transformer "manufacturers" are really assemblers. They buy components—windings, cores, insulating materials, switching mechanisms—from specialized suppliers, then integrate them into finished products. This model works fine in stable supply chain conditions. It becomes a liability when those supply chains break.

Astor started its R&D activities in 2006 and its first project supported by TUBITAK (Scientific and Technological Research Council of Turkey) was in 2009. As a result, ASTOR received the R&D center certificate in 2016.

The R&D center certification was more than a bureaucratic designation. It signaled Astor's strategic intent to move from assembly to true manufacturing—developing proprietary designs and producing the complex internal components that other companies had to import.

ASTOR has a total of 66 personnel with 47 R&D Researchers, 13 R&D Technicians and 6 R&D Support Personnel within the scope of R&D center. The company aims to strengthen its competent personnel infrastructure especially by encouraging graduate and postgraduate studies. Aware of the importance of developments in the field of basic sciences, the R&D center studies are continued by encouraging the graduates of chemistry department to continue their postgraduate education.

The investment paid off. In 2023, Astor ranked first as the company that invests the most in R&D within the energy sector.

But the crown jewel of vertical integration is the testing laboratory. In high-voltage engineering, you can design a transformer, you can build it, but if you cannot certify it, you cannot sell it. International utilities and grid operators require transformers to pass rigorous type tests, typically conducted at accredited laboratories that can simulate the extreme conditions—short circuits, lightning impulses, temperature extremes—that transformers must survive in operation.

HVL1 and HVL-2 testing laboratories in Europe with Astor joint 2200 m² test area and 1000MV to 800kv capacity is Turkey's largest testing laboratories. In addition to HVL-1 and HVL-2 laboratories, there are OG-1, OG-2, OG-3, OG-4 laboratories for transformer tests.

Both laboratories can be tested separately with 500MVA 400kV test measurement capacity and at the same time they can work in parallel and reach 1000MVA 800kV capacity.

The laboratory is accredited according to ISO / IEC 17025 standard in 2013 and is managed by fulfilling the requirements of ISO / IEC 17025 quality management system.

Before building this capability, Astor had to ship heavy equipment to foreign laboratories—often in Germany or the Netherlands—for approval. Each certification cycle could take months and cost hundreds of thousands of dollars. Now, the company can conduct testing on-site, slashing R&D cycles from months to weeks.

The strategic value of this capability became apparent when supply chain shocks hit. Companies that relied on external component suppliers and testing laboratories found themselves at the mercy of global logistics disruptions. Astor, having internalized critical capabilities, could iterate faster and maintain production continuity when competitors faced two-year backlogs.


V. The Perfect Storm: Supply Chains & The Supercycle (2020–2022)

Then came the pandemic. And everything changed.

The COVID-19 pandemic disrupted supply chains throughout the world. The grid component sector, including transformers, was no exception as shortages of material, equipment, and labor created slowdowns in both manufacturing and construction. As pandemic restrictions were lifted, projects that had been delayed deliberately, or because of component unavailability, suddenly were resumed. This created supply chain ripple effects that are still subsiding.

But COVID was only the trigger. The underlying forces driving transformer demand were structural, not cyclical.

Rising demand for transformers has exacerbated supply chain challenges, driven by increasing electrification across the U.S. and global economies, the build-out of renewable electricity generation, and growth in large-load customers such as data centers. This has led to a sharp increase in prices.

A quarter of the world's renewable-energy projects may be delayed while awaiting transformers to connect them to local grids, according to the Wood MacKenzie report. In India, the wait for 220-kilovolt transformers has leaped from 8 to 14 months, potentially holding up nearly 150 gigawatts of new solar development.

The transformer shortage became existential for grid operators. The transformer shortage touches utilities, homeowners, businesses, rail systems, EV charging stations—anyone needing a grid connection. In Clallam County, Washington state, officials in May 2022 began to deny new home-construction requests because they couldn't get enough pad-mounted transformers.

Transformer lead times have continued an upward trajectory and now stand at 115 to 130 weeks—more than two years—on average. Lead times for large transformers, both substation power transformers and generator step-up (GSU) transformers, have surged to 120 to 210 weeks—or 2.3 to 4 years. At the same time, depending on the size and application, transformer prices have risen 60% to 80% on average since January 2020.

For Astor, this was the moment the Ankara investment transformed from speculative bet to strategic asset. Because the factory was built in 2016 with excess capacity, the company had manufacturing bandwidth when competitors were fully booked for years.

The export pivot accelerated. In the first half of 2025, exports accounted for 50% of total revenue. Ranked 87th on the ISO 500 list in 2023, the company rose to 74th place in 2024 and has strengthened its leading position among domestic companies in the production of transformers and switching products.

53 percent of exports are made to EU countries. European utilities, facing the twin pressures of renewable energy mandates and the realization that Asian supply chains were too distant and unreliable, discovered a capable manufacturer on their doorstep—one that could ship via Mediterranean routes with lead times measured in weeks rather than years.

Currency dynamics added a powerful tailwind. Operating in Turkey meant labor, materials, and overhead were denominated in Turkish Lira—a currency that depreciated significantly against the Euro and Dollar. Export revenues converted back to Lira created margin expansion that domestic competitors in higher-cost jurisdictions could not match.


VI. Inflection Point #3: The IPO & Corporate Maturity (January 2023)

By late 2022, Astor was at an inflection point. The demand surge had filled order books and generated exceptional profits. But the company faced a strategic question: how to capitalize on the opportunity at scale?

The answer was a public offering.

Shares offered to the public listed on BIST STARS with a base price of 12.5 TL, the ticker code "ASTOR" and the continuous trading method as of January 18, 2023. With the high IPO demand, Astor Enerji launched an outstanding IPO with an IPO revenue of 2 billion 625 million TL and sales to 691 thousand investors.

The numbers were remarkable. Nearly 700,000 individual investors participated in the IPO—an extraordinary level of retail demand for an industrial company. The offering was multiple times oversubscribed.

Astor Enerji will use the IPO revenue for working capital and to increase its capacity as well as to invest in solar power plants and charging stations for electric vehicles.

But the IPO was about more than capital. It was about institutional credibility. Transformers are critical infrastructure. Global utilities sign contracts spanning ten years or more. Before committing to such relationships, procurement departments at European grid operators need to see transparent financials, audited accounts, and the governance structures that come with public company status. The IPO was, in effect, a "graduation" ceremony—marking Astor's transition from a family enterprise to a globally credible industrial partner.

The market response validated the thesis. Market value increased over 300 percent since the beginning of the year when the IPO was conducted. Astor Enerji was included in the BIST 30 Index as of July 1, 2023.

Entry into the BIST 30—Borsa Istanbul's blue-chip index comprising the thirty largest and most liquid stocks—was extraordinarily rapid. Most companies take years to achieve this milestone. Astor accomplished it in six months.

Borsa Istanbul announced that for the 2023 third quarterly period, Astor Enerji shares were included in the BIST 100, BIST 50 and BIST 30 pay indices. In this period only Astor Enerji was added to the BIST 30 index and the "BIST Non-Bank Liquid 10" Index.

The inclusion triggered institutional buying from index funds and attracted international investor attention. Astor became Turkey's poster child for the global electrification theme.


VII. Beyond Hardware: Astor Charge & The Ecosystem (Present Day)

The IPO proceeds signaled a strategic evolution: Astor was becoming an energy player, not just a manufacturer.

Astor Enerji is an Ankara-based specialist enterprise in manufacturing of medium voltage switching products and compact transformer substations. It was among the first companies in Turkey to obtain a "Charging Network Operator License" issued by the Republic of Turkey Energy Market Regulatory Institution (EPDK).

The launch of Astor Charge represented a textbook vertical integration play. EV charging stations require transformers and substations to connect to the grid. Astor manufactures both. By building its own charging network, the company creates guaranteed demand for its core products while capturing the downstream revenue from electricity sales to EV owners.

Siemens has been awarded one of the largest single orders for SICHARGE D electric vehicle (EV) fast chargers globally to date. The order, which comprises of 200 EV fast chargers and digital services, was made by Astor Enerji to fulfill its plans to build charging stations throughout Turkey. The company intends to set up chargers every 200 kilometers along highways all over the country and at a number of shopping malls.

As of 2023, 31 provinces had a total of 302 charging units installed and put into use. By the end of 2024, the target was to complete the installation of 800 slot stations, including AC/DC.

The Turkish EV market presents a compelling opportunity. The Turkish EV market is growing at a fast pace. Current projections indicate that Turkey's charging station infrastructure will increase around 50 percent through 2030, when up to two million electric cars are expected to be on the road in the country.

The sustainability angle completes the ecosystem story. The rooftop solar power plant with an installed capacity of 3,300 kW is expected to generate up to 5 million kW of electricity annually. With these production values, it is aimed to meet the annual electricity consumption need of the production facility. The most important contribution to the national economy is the generation of electricity from renewable energy by own resources.

ASTOR has established the first "Roof Solar Power Plant project" in the organized industry region and has become the pioneer company.

The "Green Factory" narrative matters for European buyers increasingly subject to ESG mandates and supply chain due diligence requirements. A transformer manufacturer that powers its own operations from renewable energy presents a far more attractive supplier profile than one dependent on coal-fired electricity.

Looking forward, the partnership with Energy Vault signals the next frontier. By combining Energy Vault's portfolio of advanced long- and short-duration energy storage hardware solutions and AI-driven software platform with Astor Enerji's manufacturing scale and global delivery track record, the partnership unlocks operational efficiency. Energy Vault will source over 1 GW of transformers and high-voltage equipment from Astor to support its BESS projects.

Energy Vault will deliver to Astor Enerji 2 GWh of B-VAULT systems for its grid-connected PV projects, combining advanced energy storage technology with Energy Vault's VaultOS software platform.

This two-way partnership—Astor supplying transformers to Energy Vault's battery storage projects globally, Energy Vault providing storage systems for Astor's solar installations—represents the strategic evolution from component manufacturer to integrated energy solutions provider.


VIII. The Playbook: What Makes Astor Work

Stepping back from the chronological narrative, several strategic elements emerge that explain Astor's positioning:

Capacity as Strategy. In heavy industry, availability is the best ability. By overbuilding capacity in Ankara before demand materialized, Astor won market share when the shortage hit. While competitors quoted two-year lead times, Astor could deliver. In industrial procurement, the supplier who can actually ship product captures orders that theoretical capacity cannot.

The "China Plus One" Beneficiary. Global manufacturing is experiencing a structural shift. European and American companies, burned by pandemic supply chain disruptions and wary of geopolitical tensions with China, are seeking production bases closer to end markets. European buyers have shown a steady increase in demand for inspections and audits in Turkey (+27% YoY in Q2 2024), making it a key supplier partner.

Turkey occupies what might be called the "Golden Middle"—not as cheap as China or Southeast Asia, but far closer to European markets, sharing a customs union with the EU, and politically aligned with Western institutions. Logistics network disruptions have highlighted Turkey's potential as a manufacturing hub for European, Middle Eastern, and US east coast markets. Turkey's exports are highly diversified, with leading categories including the automotive industry, apparel, power grid equipment and home appliances.

Trade between the EU and Turkey rose to a record US$218.9 billion in 2024. Around 41 percent of Turkish exports were destined for the EU, while 32 percent of the country's imports were from EU member states.

Integrated Agility. By owning R&D, testing, and component manufacturing, Astor iterates faster than bureaucratic multinational conglomerates. When a customer needs a custom transformer specification, Astor can design, prototype, test, and certify entirely in-house. Global giants like Siemens or ABB, with their distributed operations and complex approval processes, often cannot match this speed.

Founder-Led to Public-Led Transition. The Geçgel family's decision to IPO—and the subsequent professionalization of management—represents a critical evolution. Many family-controlled industrial companies struggle to make this transition, but Astor navigated it successfully while maintaining the strategic vision and long-term thinking that family ownership enables. Feridun Geçgel currently works at Astor Enerji AS, as Chairman from 2015—the family remains involved but has built a professional management team underneath.


IX. Analysis: Powers & Forces

Hamilton's 7 Powers Analysis:

Scale Economies: The Ankara facility represents significant scale advantages. Continuing its production activities in Ankara, Astor Enerji has one of Europe's leading transformer production facilities under one roof in an enclosed area of 105,000 m2, established on a land of 140,000 m2 in total. Fixed costs for tooling, testing equipment, and overhead are spread across higher volumes, enabling competitive unit costs.

Process Power: The proprietary manufacturing flow and on-site testing laboratory reduce waste and time-to-market. Competitors who must outsource testing or lack integrated component manufacturing cannot replicate these efficiencies quickly.

Cornered Resource: Astor has access to highly skilled, relatively lower-cost engineering talent in Ankara compared to Germany or the United States. Turkey's engineering universities produce capable graduates at salaries that are a fraction of Western European levels. This talent arbitrage is difficult for competitors to replicate without relocating operations.

Porter's 5 Forces:

Supplier Power: High and variable. Transformers require copper for windings and electrical steel for cores—both commodities with volatile prices. The shortage and subsequent spike in the price of raw materials, especially copper (copper price increased almost 10% in 2023), has contributed significantly in increasing the price of transformers. Astor mitigates this through bulk purchasing agreements and contractual pass-through clauses that transfer commodity risk to customers.

Buyer Power: Normally utilities and grid operators wield significant procurement power. However, the current market is inverted. The transformer shortage touches utilities, homeowners, businesses, rail systems, EV charging stations—anyone needing a grid connection. When transformers are scarce, power shifts to manufacturers who can actually deliver.

Threat of New Entrants: Low. The domestic transformer manufacturing industry has had difficulties attracting and retaining qualified workers. The lack of standardization in transformer design has made automation, assembly optimization initiatives, and other technologies that aid efficient mass production more difficult. Finally, manufacturers have faced cost and regulatory uncertainty concerning electrical steel. The capital expenditure required to build a competitive facility, the years required to achieve certifications, and the scarcity of experienced personnel create substantial barriers.

Substitutes: Effectively none. There is no alternative technology that performs the voltage conversion function of a transformer. Solid-state transformers using power electronics exist in experimental form but are decades from commercial deployment at scale.

Competitive Rivalry: The transformer market is served by global giants—Major players include ABB (Switzerland), Schneider Electric (France), Siemens (Germany), GE Vernova (US), and Eaton (Ireland). However, these companies are capacity-constrained and command premium prices. Regional players like Astor compete effectively by offering faster delivery, competitive pricing, and local service capabilities.


X. Bull vs. Bear & Key Metrics

The Bear Case:

Cyclicality Risk: Is the transformer "supercycle" permanent or cyclical? Many of the largest transformer OEMs have announced capacity expansions since 2023 to address the shortage in the North American market—some US$1.8 billion to date. However, the rate of demand growth will require even more investment to rebalance the market. When supply eventually catches up with demand, pricing power could erode and margins compress.

Geopolitical and Currency Risk: Turkey's location offers advantages but also risks. Proximity to Middle Eastern conflicts, complex relations with both Russia and NATO, and recurring domestic political tensions create country risk. The Turkish Lira's chronic depreciation creates volatility in financial statements—while beneficial for export competitiveness, it complicates valuation analysis.

Raw Material Exposure: Copper and electrical steel prices remain volatile. A significant commodity price spike could compress margins if pass-through clauses lag or customers resist price increases.

The Bull Case:

Structural Demand: The grid must approximately double in capacity to achieve Net Zero targets. Transformers are non-discretionary infrastructure. Globally, electricity supplied 20 percent of the world's energy needs in 2023, and may reach 30 percent by 2030 as countries turn to electrification as a way to decarbonize.

Data Center Boom: AI infrastructure requires massive power—and massive transformers. Every hyperscale data center project requires specialized power transformers to connect to the grid. This represents a new demand vertical that barely existed a decade ago.

Regional Positioning: Astor is perfectly positioned to capture the MENA (Middle East North Africa) and European reconstruction markets. The company's geographic location, cultural connections to the Middle East, and EU-compliant production make it a logical supplier for markets underserved by capacity-constrained Western manufacturers.

Capacity Expansion: Astor Enerji has completed its land allocation studies for the purpose of increasing capacity and adding new products to its product range. The land parcel with a total area of 180,195 m² has been allocated to the company. Additional capacity provides runway for continued growth.

Key Performance Indicators to Monitor:

For investors tracking Astor's ongoing performance, two metrics are paramount:

  1. Export Revenue as Percentage of Total Sales — Currently at 50% for H1 2025, this metric captures Astor's global competitiveness and diversification away from Turkish domestic market exposure. Rising export share indicates successful penetration of higher-margin international markets.

  2. Order Backlog Duration — Not directly disclosed in public filings but inferrable from management commentary. In the transformer industry, a healthy backlog of 12-18 months provides revenue visibility; backlogs extending beyond 24 months may indicate capacity constraints that require investment.


XI. Conclusion: The Unsexy Essential

Astor Enerji represents something unfashionable in an era of software-defined everything: a physical manufacturing business making essential industrial equipment. There are no network effects, no viral user acquisition, no zero-marginal-cost scaling. Every transformer requires copper, steel, skilled labor, and factory space.

And yet, this is precisely the point. The global economy is rediscovering that physical infrastructure matters—that you cannot power AI data centers with software, that you cannot charge electric vehicles with mobile apps, that you cannot connect wind farms to grids with cloud computing.

Astor's journey from a small Istanbul transformer shop to a $2.7 billion publicly traded industrial champion illustrates what disciplined execution of an industrial strategy looks like. The Geçgel family bet on capacity before the crisis, invested in vertical integration when it was unfashionable, built testing capabilities when outsourcing was the trend, and took the company public when institutional credibility became essential.

The transformer shortage may eventually ease. New capacity is coming online globally. But the structural forces driving electrification—decarbonization mandates, EV adoption, data center proliferation, grid modernization—are measured in decades, not quarters. For as long as electrons flow through wires, they will need transformers to convert voltage levels.

Astor has positioned itself at the intersection of that essential need and the geographic opportunity that Turkey presents. In the unsexy, physical, absolutely essential infrastructure of the energy transition, that may be exactly where long-term value creation resides.

Last updated: 2026-01-27
